City sets summer projects list

Published 5:30 am Wednesday, July 2, 2025

tsr
1/3
tsr
Sequim Gazette photo by Matthew Nash

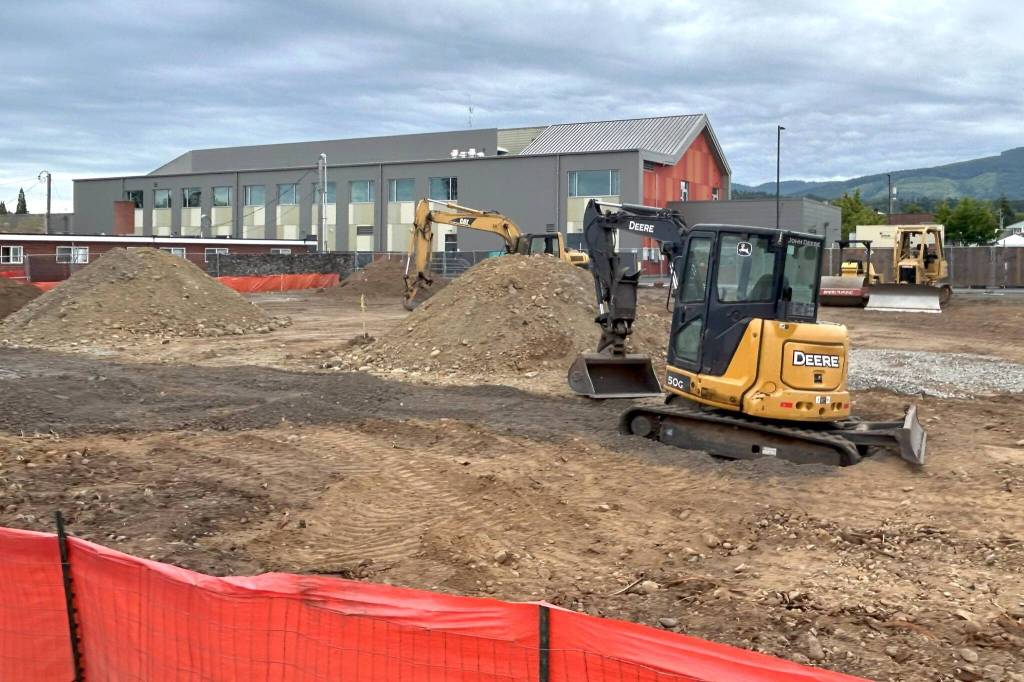

A new parking lot next to the Sequim Civic Center will be completed by the end of the summer, according to City of Sequim staff. The city purchased three lots adjacent to the center in June 2022 to convert the properties into a parking lot for city staff. The lots were also known for common calls for 911.
Sequim Gazette file photo by Matthew Nash/ The City of Sequim is replacing one bridge along the Olympic Discovery Trail and adding a small one west of the pictured platform so a mower can travel between portions of Carrie Blake Community Park. The platform and a few other bridges were found to be in working order, city staff said.

With the completion of paving for the Fourth Avenue water main project in mid-June, a number of infrastructure and road projects are on tap for the remainder of summer and the rest of the year in the City of Sequim, according to staffers.

Curb replacements

Work to replace 61 deficient ADA ramps across the city is anticipated to begin July 7 by Earthwork Solutions, LLC.

City councilors agreed on May 27 to an approximate $808,000 contract with an $80,800 contingency for the project. Earthwork’s bid was just under the city staff’s estimate, and it’s mostly funded at about 82.4% by a Transportation Improvement Board Grant. The remainder comes from the city’s Transportation Benefit District and Stormwater funds, according to city documents.

Nick Dostie, Sequim’s city engineer/deputy director of public works, said the project has a deadline of substantial completion by mid-November.

Repaving efforts

Portions of Washington Street, West Sequim Bay Road and River Road are expected to be repaved this summer while Priest Road is anticipated to be rebuilt in the western portion of the city.

For the Washington Street Pavement Rehabilitation project, Lakeside Industries will place about 1,040 tons of hot mix asphalt along Washington Street from Seventh Avenue to Ninth Avenue.

Lakeside was the lowest of two bidders at just under $443,300 but about $20,000 more than city staff’s estimate. The project is funded by a Surface Transportation Block Grant at about 86.5%, staff report.

Lakeside will also pave West Sequim Bay Road starting this week (June 30) from Whitefeather Way to the eastern part of Sequim city limits with 320 tons of asphalt.

Lakeside’s bid at about $104,000 was about $25,000 less than city staff’s estimate, and funding largely comes from the city’s Transportation Benefit District.

Lakeside also won with a $1.15 million bid (about $62,000 more than city estimates) to place 2,950 tons of hot mix asphalt and replace the subgrade on Priest Road. City staff said about 86.5% of the project is funded by a Surface Transportation Block Grant.

Dostie said a timeline for Washington Street and Priest Road’s construction will be determined at July 8 meetings.

As for work on River Road, he said Department of Transportation staff are reviewing the project that will pave the road from the U.S. Highway 101 overpass to the nearby roundabout.

Civic Center parking lot

The city’s new parking lot on West Spruce Street started the first week of June.

Dostie said they look to wrap up the project this summer.

Hoch Construction of Port Angeles — which is finishing the renovation and expansion of the Sequim Library this summer, too — won the approximate $619,000 contract to level the lots from 153-169 W. Spruce St. and create a gated parking lot with 40 spots north of the city hall. It will include four pay-to-use electric vehicle charging spots.

Originally slated for 2024, funding for the project includes 2024 General Facility Charges and General Fund monies, and funds from this year’s Real Estate Excise Tax (REET), General Fund, and Water and Sewer Funds.

Sequim bought the lots in June 2022 for $457,500 from the city’s Rainy Day funds with the intent to turn the sites into a parking lot.

The city had been in negotiations off and on with former owner Ron Fairclough for more than a decade, he said.

Law enforcement reported often to the properties for an array of charges related to Fairclough’s renters, he said. His home at 153 W. Spruce St. burned down in June 2021, along with a dental lab, garage and a fifth wheel trailer.

Park pedestrian bridges

City staff report that two pedestrian bridges budgeted and ordered in 2024 for Carrie Blake Community Park are anticipated to be shipped the week of July 21.

Dostie said if there are no damages in transit, they’ll seek a bid to remove the old bridge and install the new ones.

Sequim city councilors agreed in the city’s 2024 budget for $350,000 to replace four aging pedestrian bridges across Bell Creek.

Public Works Director Paul Bucich said in an interview they are now only replacing one bridge on the Olympic Discovery Trail and adding one wide enough for a mower. Cost to manufacture the bridges was approximately $180,000, Bucich said.

Dostie said they hope to install the bridges sometime this year depending on when permitting comes through the Department of Fish and Wildlife.

Other projects

City staff noted a few other upcoming summer projects:

• Paving the gravel path around the James Center for the Performing Arts’ bandshell in Carrie Blake Community Park

• Stormwater improvements at the intersection of Brown Road and Washington Street will begin July 21 and finish in mid-August

• Staff will inspect city parks and facilities for ADA-compliance for a Transition Plan
